The installation pipeline is where evSuryam stops being a quoting tool and becomes your operations board. Every rooftop solar job lands on a Kanban board, moves left-to-right through 13 stages, and carries its assignee, crew, target date, and notes the whole way. Your office sees exactly where each project sits without a single phone call to site.
Overview
Open Site Visits in the left sidebar. The board has eight columns. Related stages share a column, one above the other — Material Dispatched sits above Material Delivered, DC Wiring above AC Wiring — so the whole 13-stage job fits on one board. Each card shows the customer, system size in kW, the target date with a progress bar, and who it's assigned to. Drag a card into the next stage as work progresses; the office and the field team see the same picture. You can also switch to a list view and filter by stage.

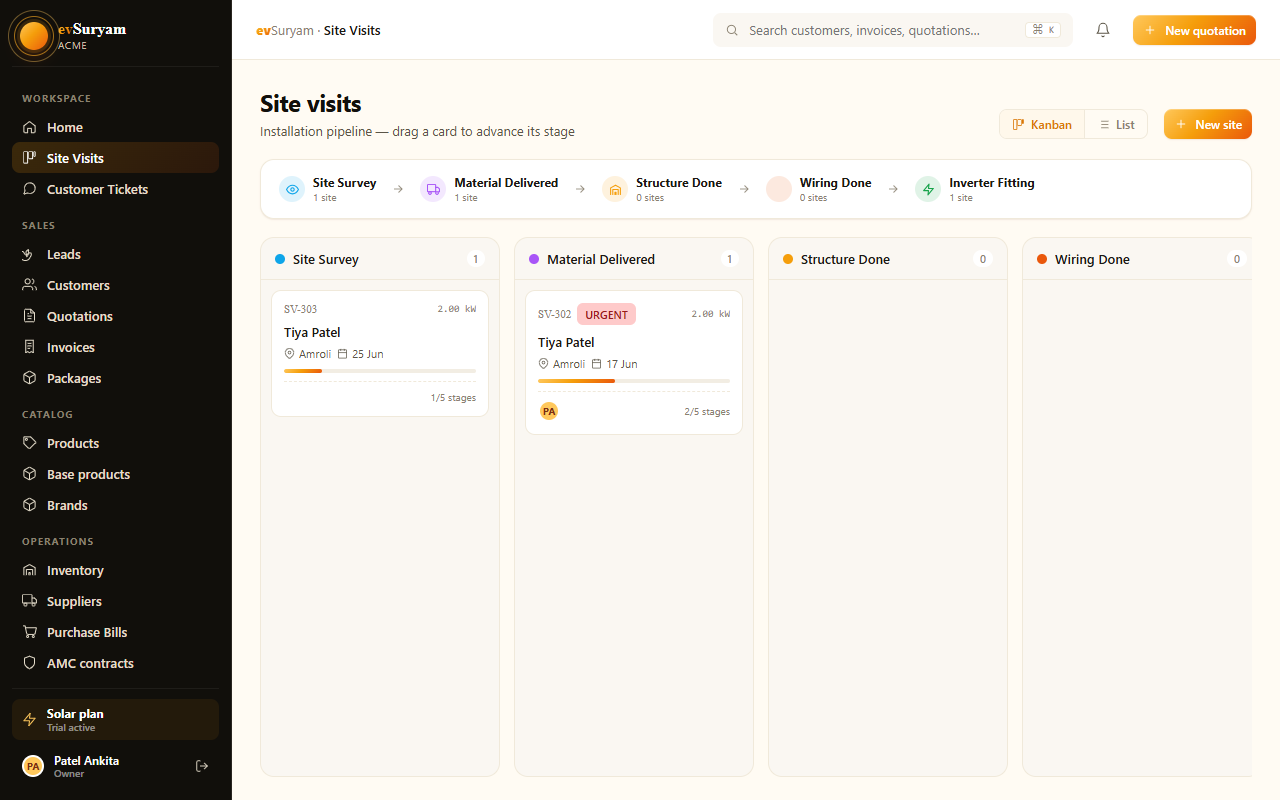

public/images/docs/installation-pipeline.pngOne board, one truthThe pipeline replaces the chat groups and paper job-cards most vendors juggle. When a card reaches Commissioning, accounts knows the job is nearly done — no status meeting required.
Opening a new site
When a customer signs, open a site for the job:
- In Site Visits, click New site.
- Optionally pick the invoice it comes from, then choose the customer.
- Enter the city, system capacity (kW), and site address.
- Set the starting stage (usually Site Survey), a target commissioning date, who it's assigned to, and the crew. Mark it urgent if it needs priority.
- Save. A new card appears in the chosen stage.
Get the quotation and invoice right first and the site starts from clean customer details.
The 13 stages in 8 columns
Every rooftop installation in India follows the same arc. evSuryam tracks it as 13 stages, grouped into eight columns so related work sits together:
| Column | Stages (top → bottom) |
|---|---|
| Site Survey | 1. Site Survey |
| Material | 2. Material Dispatched → 3. Material Delivered |
| Structure & Panels | 4. Structure Installation → 5. Solar Panel Installation |
| Wiring | 6. DC Wiring → 7. AC Wiring |
| Inverter & Earthing | 8. Inverter Installation → 9. Earthing Installation |
| Commissioning | 10. Testing & Commissioning → 11. Net Meter Installation |
| Inspection & Approval | 12. Inspection & Approval |
| Project Completed | 13. Project Completed — the last column, so finished jobs sit apart from work in progress |
A card always moves forward through the numbered stages — down within a column, then on to the top of the next column.
Stage-by-stage exit criteria
A card should only move on when the stage is genuinely complete. Use the exit criteria below as your team's definition of done — they keep half-finished jobs from looking finished on the board.
| Stage | Exit criteria — done when… |
|---|---|
| 1. Site Survey | Roof area, tilt and shade-free zones measured; sanctioned load and meter number recorded; any deviation from the quote flagged to sales. |
| 2. Material Dispatched | Panels, inverter, structure and BOS loaded from your warehouse or supplier. |
| 3. Material Delivered | All quoted items on site and checked for damage. |
| 4. Structure Installation | Foundations or ballast done; rails and mounting structure erected, plumb and torqued. |
| 5. Solar Panel Installation | All panels mounted and clamped on the structure. |
| 6. DC Wiring | Strings wired with MC4 terminations; DCDB fitted; polarity checked. |
| 7. AC Wiring | AC cable run from the inverter location to the ACDB and meter board. |
| 8. Inverter Installation | Inverter mounted and connected on both the DC and AC sides. |
| 9. Earthing Installation | Earthing pits and lightning arrestor installed; earth resistance measured. |
| 10. Testing & Commissioning | System energised, insulation and string tests passed, generation verified. |
| 11. Net Meter Installation | The DISCOM has installed and sealed the bi-directional meter. |
| 12. Inspection & Approval | DISCOM inspection passed; subsidy documents uploaded where applicable. |
| 13. Project Completed | Plant handed over with the commissioning report; final invoice raised and payments recorded. |
Moving a project through
Driving a job from survey to completion is a matter of moving cards and keeping each stage honest.
- Open the Site Visits board and find the project's card in its current stage.
- Do the work for that stage on site, then check it against its exit criteria. If anything is incomplete, leave the card where it is.
- Drag the card into the next stage, or open it and click Advance stage. You can add a remark as you update it. A card can't move back to an earlier stage.
- Every move is recorded in the card's stage history, so you build a timeline of how long each stage took.
- If a job stalls — a roof problem, a delayed DISCOM approval — leave it in place and add a note. The board now shows your bottleneck at a glance.
Don't skip Site SurveyOpening a job and dragging it straight to Structure Installation to "save time" is how vendors end up with a structure that doesn't fit the shadow-free area. The survey stage exists to catch the gap between what was quoted and what the roof actually allows — honour it.
Assigning people & crews
A project on the board means little until someone is responsible for it.
- Open the card and choose who it's assigned to — the team member accountable for the job.
- Record the crew working on site — it's saved with the site and shown when you open the card.
- Set a target commissioning date so the office can spot slipping jobs early, and flag urgent jobs.
- Field staff can follow and update their sites from the evSuryam Android app.
Who can create, move, or delete sites is governed by the Site Visits permission on each role — configure this under team & roles, with a worked example in the custom roles example.
Customer email updates
Each time a card moves to a new stage, the customer receives an email telling them where their installation has reached, including the remark you added (if any). Your customers stay informed without anyone on your team writing a separate update — keeping the board current is the customer communication.
Use the remark wellA short, specific remark — "Structure up; wiring scheduled Thursday" — turns an automatic email into a reassuring, personal update and heads off "what's happening?" calls.
Commissioning, net meter & handover
The last three columns turn a built plant into a live, approved solar connection. In India this means coordinating with the DISCOM — and each step has its own stage on the board:
- Testing & Commissioning — Power up the inverter, confirm generation, and run your commissioning checks.
- Net Meter Installation — The DISCOM installs and seals the bi-directional meter that nets your customer's export against their import.
- Inspection & Approval — The DISCOM inspects the installation against the approved net-metering application.
- Project Completed — Hand the system over to the customer with the commissioning report, and make sure the final invoice is raised and payments recorded.
For systems claiming central subsidy, the commissioning paperwork and net-meter installation are also what unlock the subsidy disbursement — see the PM Surya Ghar subsidy guide for the National Portal steps that run in parallel.
